Wrong date in Gantt Pro
Discussion Open
Good morning,
I have a strange behavior on soma Gantt Pro dates.
If I create a task, starting on July 19th for 5 days (workable week), when I see it on Gantt Pro, I see the end moved to Monday 26th ..... :-(
Any idea why such behavior ?
Thanks
Fabrice
Files:
Capture d&rsquo...
Could be your resource does not work in weekends?
Could be your resource does not work in weekends?
Hello Fabrice. I was not able to reproduce this on MindManager 21.1.212. Which version of MindManager are you using? Is it possible for you to attach a test map that reproduces the issue?
Hello Fabrice. I was not able to reproduce this on MindManager 21.1.212. Which version of MindManager are you using? Is it possible for you to attach a test map that reproduces the issue?
Thanks for your feedback,

I probably found the root cause: in this map I have a consolidated link to another one. This one use a Task consolidation option but no dates nor resource.
If I remove this consolidated link it works now perfectly !!
To be honnest I don't understand the reason ... but it works ;-)
Thanks for your feedback,
I probably found the root cause: in this map I have a consolidated link to another one. This one use a Task consolidation option but no dates nor resource.
If I remove this consolidated link it works now perfectly !!
To be honnest I don't understand the reason ... but it works ;-)

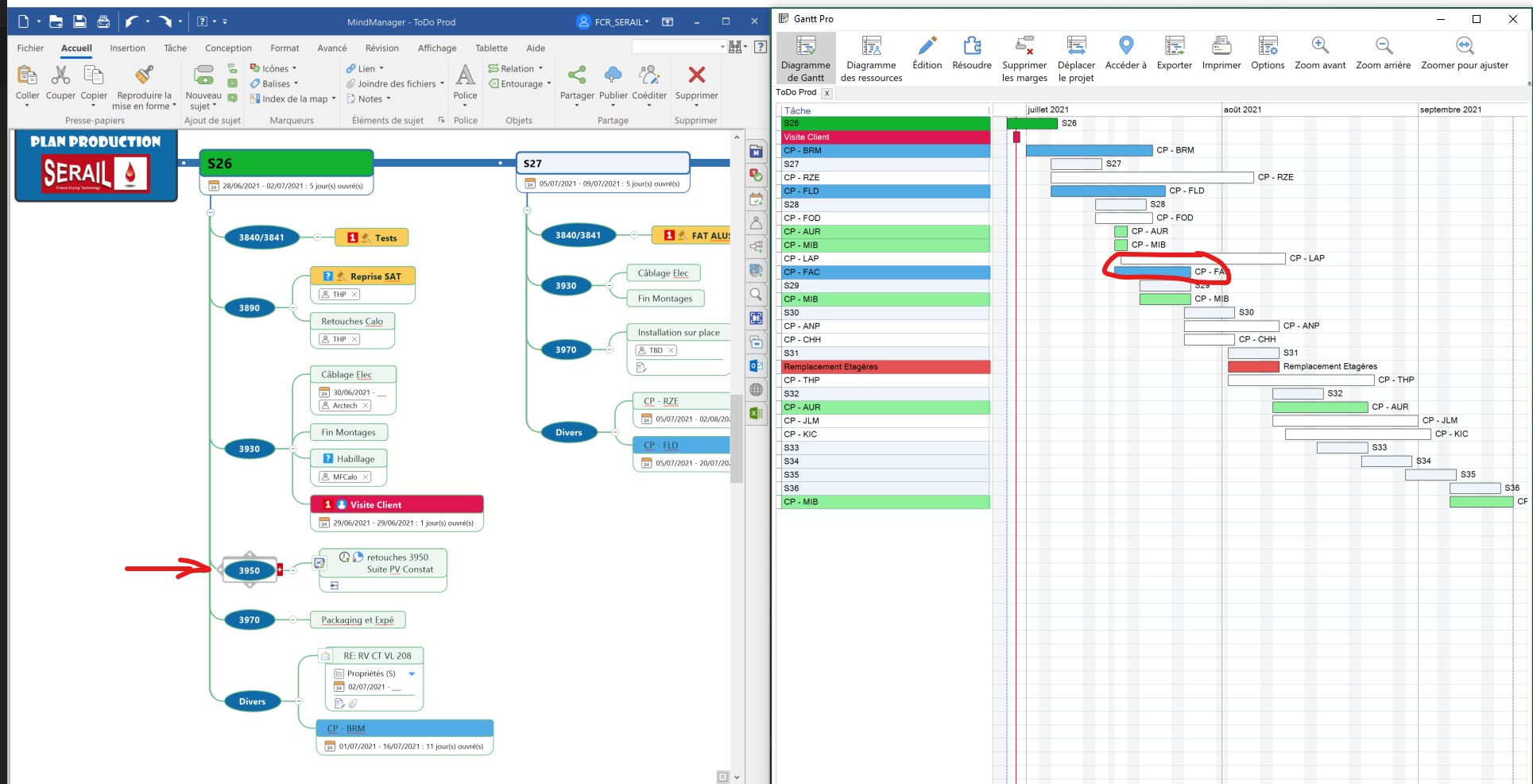

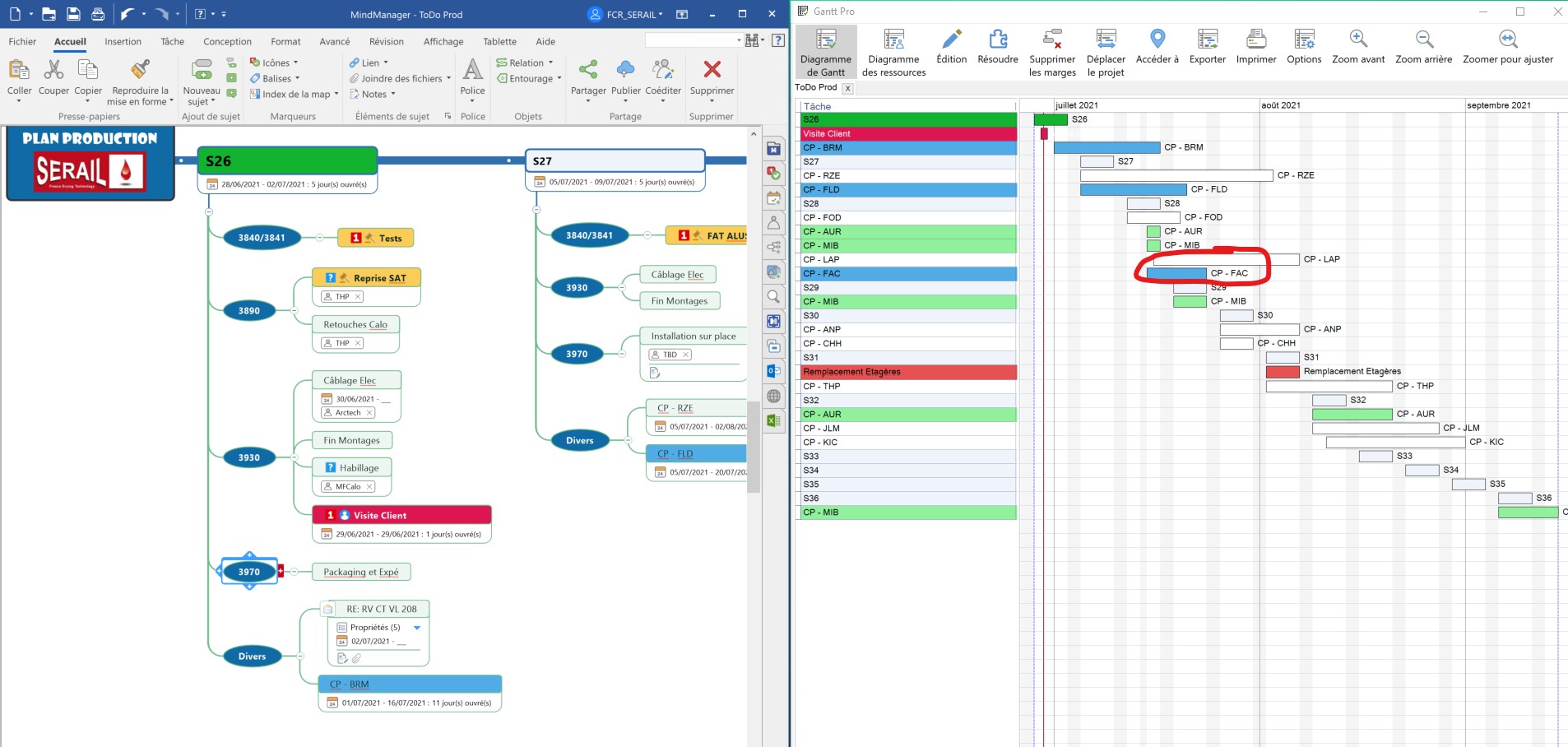

Hello Fabrice. I am glad it is working, but this sounds like something that should be investigated. Was the map roll-up link on either the S29 or CP-MIB tasks in your map? I will try to reproduce this.
Hello Fabrice. I am glad it is working, but this sounds like something that should be investigated. Was the map roll-up link on either the S29 or CP-MIB tasks in your map? I will try to reproduce this.
---
